Cycle Time Metric

This article explains the Cycle Time Metric, which tracks how long it takes code to go from first commit to production. It highlights key stages like coding, review, and deployment to help teams improve efficiency and collaboration.

Steven Silverstone
Updated by Steven Silverstone
Definition

Cycle Time measures the total time required for code to move from the beginning of implementation to production deployment.

Specifically:

Cycle Time = Time from coding start to production deployment

Only pull requests that have completed the full lifecycle — including deployment to production — are included.

Components of Cycle Time

Cycle Time is composed of four sequential phases:

1. Coding Time

Time from:

  • First commit in a branch
    or
  • Jira issue moved to In Progress (if Jira-based coding time is enabled)

Until:

  • Pull request (PR) creation

If Jira-based coding time is enabled, the coding start timestamp is derived from Jira workflow transitions.

See: Jira-Based Coding Time

2. Pickup Time

Time from:

  • PR creation

Until:

  • First review activity begins

Pickup Time reflects review responsiveness and team collaboration efficiency.

See: Reducing Pull Request Pickup Time

3. Review Time

Time from:

  • First review activity

Until:

  • PR merge

Review Time reflects review cycle efficiency.

4. Deployment Time

Time from:

  • PR merge

Until:

  • Code is deployed to production

Deployment detection depends on configured production signals and integration settings.

How the Metric Is Calculated

Cycle Time is calculated as:

Production deployment timestamp – Coding start timestamp

Where:

  • Coding start = first commit timestamp
    or Jira In Progress timestamp (if configured)
  • Production deployment timestamp = first deployment containing the merged PR

Only PRs that have been deployed to production are included.

For a detailed technical explanation, see:

Cycle Time Calculation in LinearB

Normalization

The headline value is normalized to the selected time bucket.

For example:

  • Daily view → Average cycle time of PRs completed that day
  • Weekly view → Average cycle time of PRs completed that week
  • Monthly view → Average cycle time of PRs completed that month

The headline represents:

Average Cycle Time of PRs that completed the full lifecycle within the selected period

This is an average duration, not cumulative time.

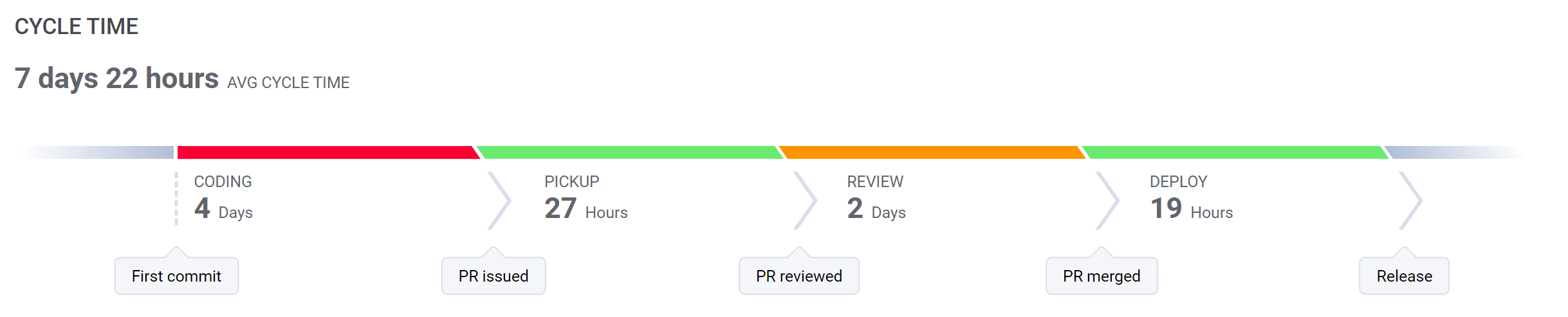

How the Metric Is Displayed in the Dashboard

Headline Value

Displays the average cycle time for completed PRs in the selected time range (e.g., 1d, 9h on average).

Aggregation options (AVG, P50, P75, P90) adjust percentile view.

Time-Based Chart

Each chart point represents:

Average (or selected percentile) cycle time of PRs completed within that specific time bucket

Why This Metric Is Useful

Cycle Time reflects end-to-end delivery speed.

It helps teams:

  • Identify bottlenecks across coding, review, or deployment
  • Improve responsiveness
  • Shorten time-to-value
  • Align with DORA delivery performance standards

Reducing Cycle Time typically improves overall delivery agility.

Relationship to Other Metrics

Metric

Measures

Coding Time

Development effort duration

Pickup Time

Review responsiveness

Review Time

Review process duration

Deployment Time

Release pipeline speed

Deploy Frequency

Release cadence

Change Failure Rate

Deployment quality

Merge Frequency

Integration cadence

Cycle Time measures the complete delivery journey.

Data Sources

Cycle Time is derived from:

  • Git commit metadata
  • PR creation and merge timestamps
  • Review events
  • Deployment logs
  • Jira workflow transitions (if enabled)
Tunable Configurations

Cycle Time may be influenced by:

  • Jira-based coding start configuration
  • Production deployment detection configuration
  • Branch inclusion/exclusion rules
  • Working day exclusion settings

Excluding non-working days affects calculations.

See: Exclude Non-Working Days from Cycle Time

Benchmarking Guidance

High-performing teams aim to:

  • Reduce pickup delays
  • Keep review cycles efficient
  • Deploy frequently
  • Break work into smaller batches

Smaller deployments can help reduce downstream failure risk.

See: Reducing Change Failure Rate Through Smaller Deployments

Limitations
  • Requires successful production deployment to compute full cycle time.
  • Backfilled deployment data may adjust historical values.
  • Long-lived branches can inflate coding time.
  • Inaccurate Jira transitions affect coding start accuracy.
  • Small sample sizes may cause volatility.

Cycle Time measures delivery duration, not code quality.

Stakeholder Use Cases

Engineering Managers

Monitor end-to-end delivery speed and identify bottlenecks.

Team Leads

Improve review responsiveness and deployment cadence.

DevOps / Platform Teams

Optimize CI/CD pipelines and production release flow.

Product Leadership

Measure time-to-value for delivered work.
